Budget Management

On the [Cost & Finance > Budget Management] page, you can set a spending budget per organization, watch how much of it has been consumed, and get notified before it runs out.

Viewing Budgets

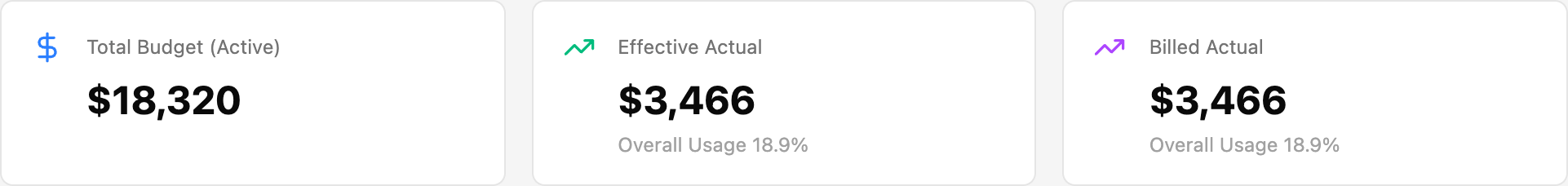

Summary Cards

CardDescription
Total Budget (Active)Sum of every active budget
Effective ActualTotal cost recorded against those budgets on the Effective Cost basis, with Overall Usage shown underneath as a percentage
Billed ActualThe same total measured on the Billed Cost basis, with its own Overall Usage percentage
ℹ️
The figures on this page come from the last calculated snapshot rather than a live query. To refresh a specific budget, open it and use Sync on its detail page.

Budget Table

ColumnDescription
NameThe user-defined name. Click a row to open the detail page
OrganizationThe organization the budget belongs to
PeriodPeriod type — Monthly / Quarterly / Yearly
Budget AmountThe committed amount for the period
Cost vs BudgetTwo progress bars — Effective Cost and Billed Cost — each with its own usage percentage. The percentage is the real burn rate and keeps counting past 100% (a budget of $1,000 with $1,800 spent reads 180%) up to 999%, beyond which it reads 999%+; only the bar stops at full width. Hover a bar to see the remaining amount, which goes negative once the budget is exceeded
Budget StatusActive / Expired / Not Started
Threshold StatusExceeded / Critical / Warning / Normal
Budget ManagerThe person responsible for the budget

Use Set Display in the ⋮ menu to change rows per page, which of these columns are visible, their order, and which are pinned to the left (up to 2 — Name is pinned by default, so it stays visible while you scroll horizontally).

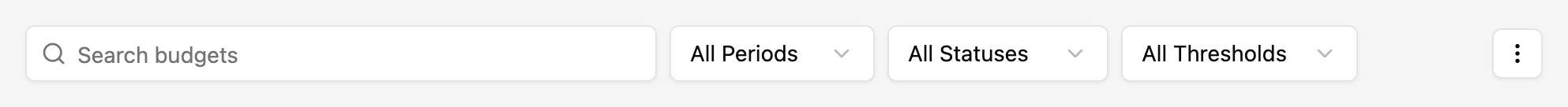

Toolbar and Filters

UI elementDescription
Search by budget nameSearch budgets by name
FilterOpens the filter panel with three axes — Period (Monthly / Quarterly / Yearly), Budget Status (Active / Expired / Not Started), and Threshold Status (Exceeded / Critical / Warning / Normal). The ☆ beside an axis pins it to the toolbar, and Saved filters keeps a combination for reuse
All Budget Status / All Threshold StatusThe two axes pinned to the toolbar by default
⋮Set Display (rows per page, column visibility, order, and pinning) and Refresh
ExportDownload the budgets matching the current search and filters as an Excel or CSV file

Exporting the list

Click Export and choose Excel or CSV. The file contains every budget matching the current search and filters — not just the current page — with the columns visible in Set Display in the same order. The download starts automatically; if the server refuses the export (row limit, file too large, timeout), an error toast says why instead of leaving you waiting.

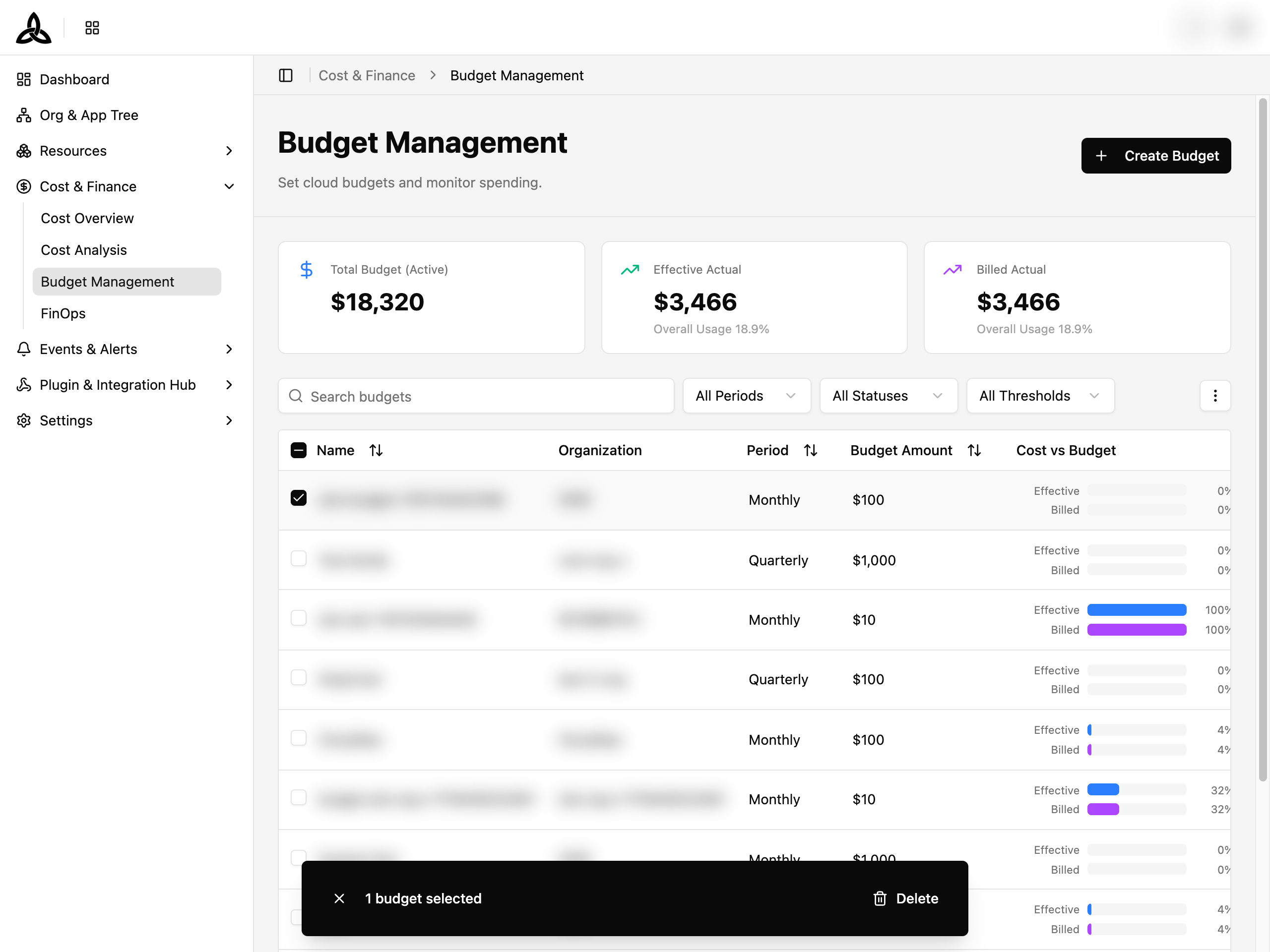

Bulk Actions

Tick the checkbox on one or more rows and a bar floats up at the bottom of the screen showing how many budgets are selected — for example 1 budget selected.

UI elementDescription
✕Clears the selection and dismisses the bar
DeleteDeletes every selected budget

Deleting in bulk asks for confirmation first and cannot be undone.

Creating a Budget

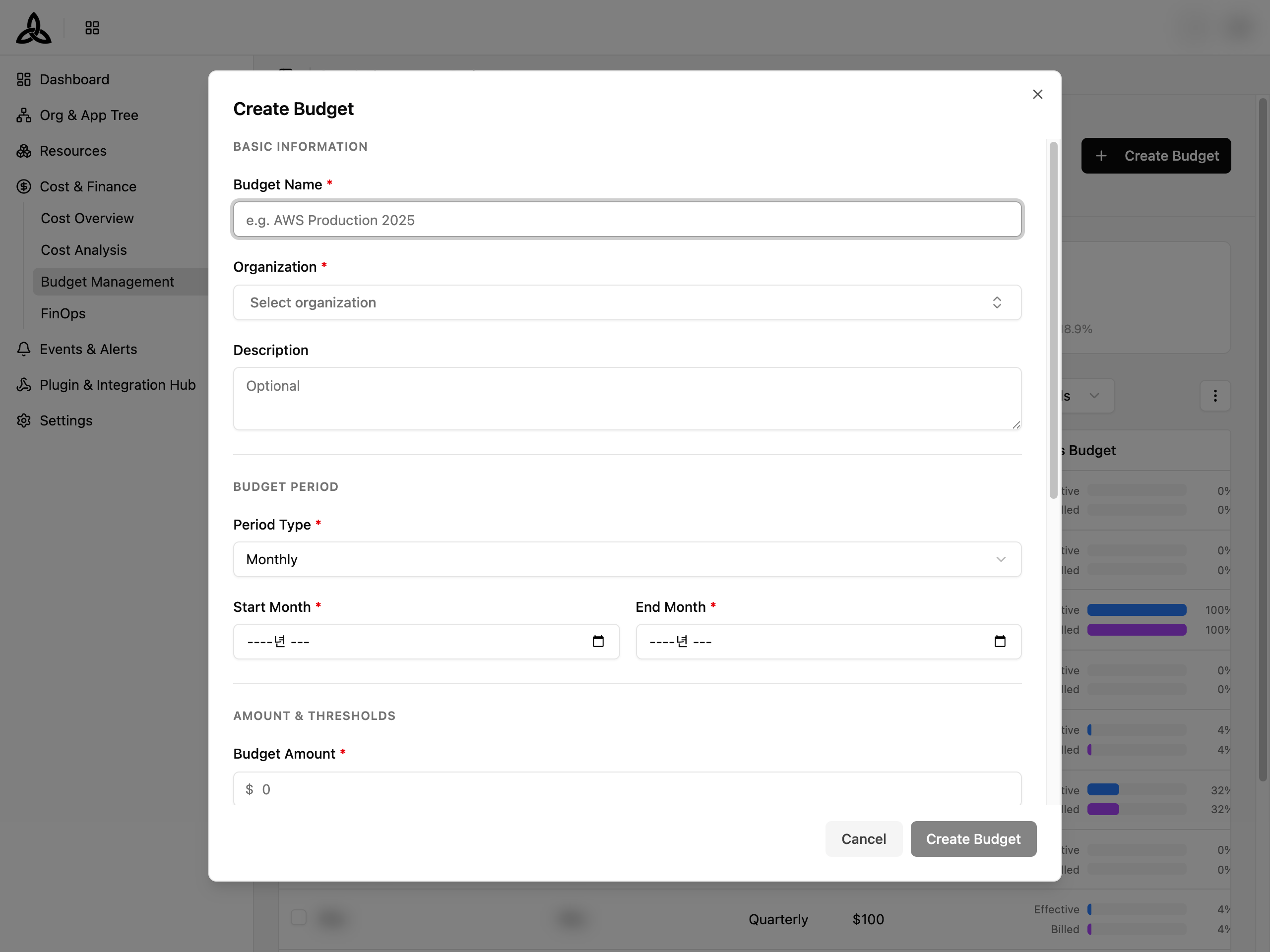

Click [+ Create Budget]

Enter the budget details

FieldRequiredDescription
Budget NameYesDisplay name of the budget
OrganizationYesThe organization the budget belongs to. Organizations that already have an in-progress budget are excluded from the list
DescriptionNoOptional free-form note
Period TypeYesMonthly / Quarterly / Yearly
Period Start / Period EndYesDepends on the period type — Start Month / End Month for monthly, a Quarter for quarterly, a Year for yearly. The period can span up to 2 years from today
DurationYearly only1 Year or 2 Years
Budget AmountYesThe amount committed for the period. Must be greater than 0
Threshold RulesYesThe percentages at which Exceeded (100), Critical (90), and Warning (80) fire — change them if the defaults don’t fit. Each must be between 1 and 200, with Warning below Critical and Critical below Exceeded
Budget ManagerNoPick a member of the selected organization, or type a name directly
Notification RecipientsNoWho gets notified when a threshold rule fires. Managers are added automatically; toggle each recipient on or off, or add more users

The form is split into Basic Information, Budget Period, and Amount & Thresholds.

Click [Create Budget]

ℹ️
One organization can hold only one in-progress budget. If every organization already has one, the organization selector reports that none are available.

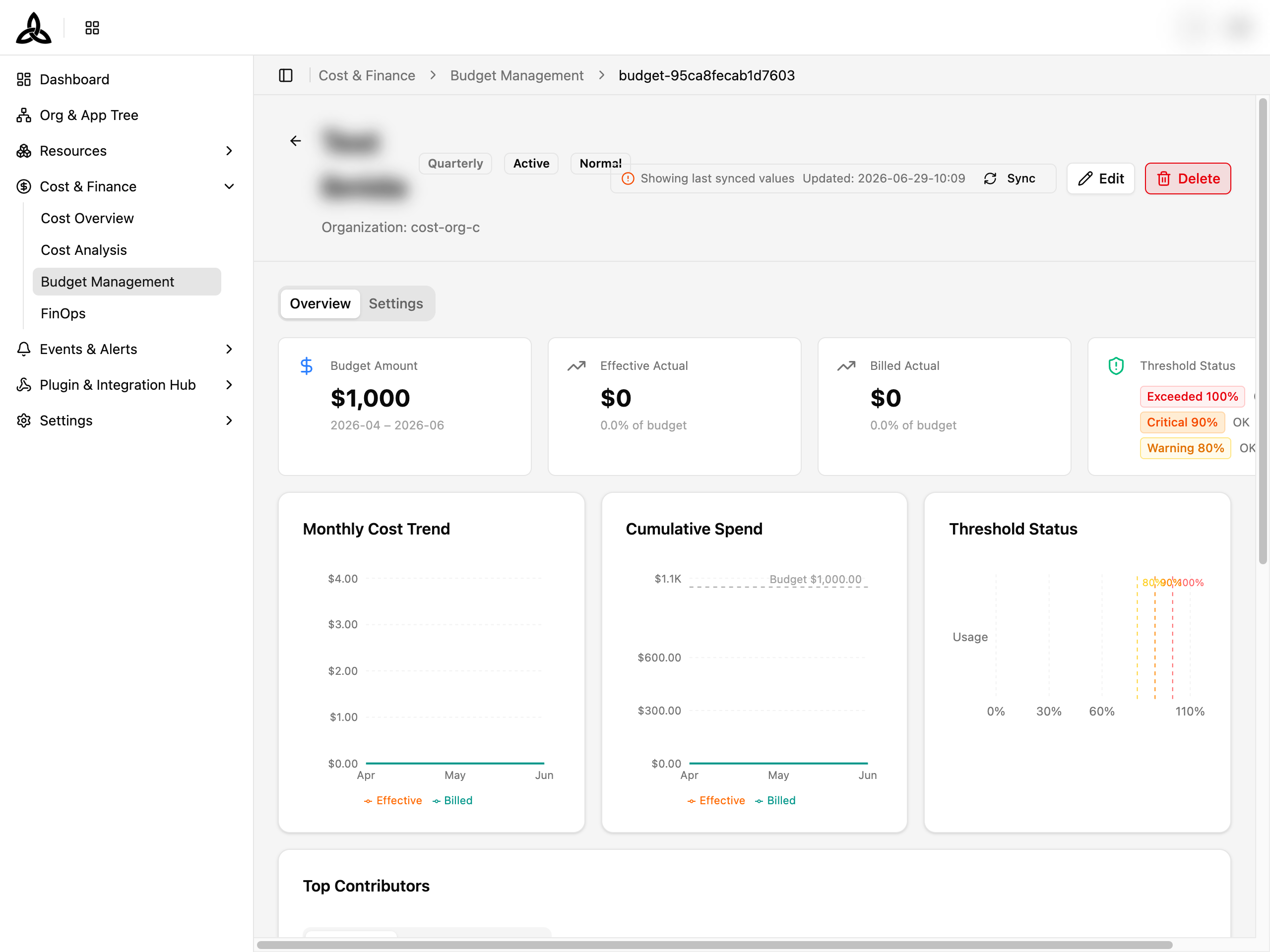

Budget Detail

Click a row to open the budget. The header shows the budget name, its period type, budget status, threshold status, and owning organization, along with when the values were last synced.

ActionDescription
SyncRecalculates this budget against the latest cost data
Edit BudgetOpens the edit dialog. Unavailable for expired budgets, which explain why on hover
DeletePermanently deletes the budget

Overview

ElementDescription
Budget AmountThe committed amount, with the covered period underneath
Effective Actual / Billed ActualSpend on each cost basis, with of budget showing the share consumed
RemainingWhat is left on the Effective Cost basis and the Billed Cost basis. It goes negative once the budget is exceeded
Threshold StatusEach rule — Exceeded 100%, Critical 90%, Warning 80% — with OK or Exceeded next to it
Monthly Cost TrendSpend per month, with Effective Cost and Billed Cost series. The Trend / Cumulative toggle switches the same data between per-month and running-total views
Threshold Status (chart)Current usage plotted against the 80% / 90% / 100% markers
Top ContributorsWhat is driving the spend, switchable between Application, Account, and Resource. A deleted application is shown by name as <name> (Deleted) rather than by ID
ℹ️
Threshold rules apply to both the Effective Cost and Billed Cost values.

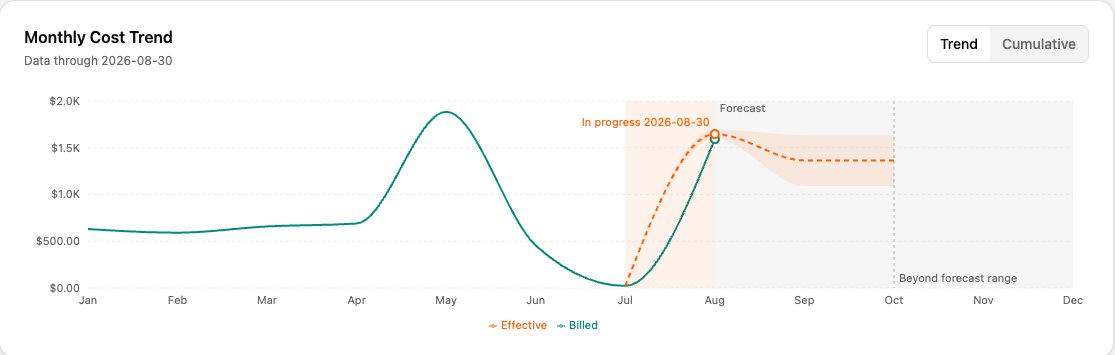

Cost forecast

The trend chart also projects where the spend is heading. Actual months are drawn as a solid line and the projection continues as a dashed line, so a forecast is never mistaken for something already spent.

MarkerMeaning
In progressThe month still running — its figure will keep moving
ForecastThe shaded region the projection covers, with a band showing its range

The axis ends at the last month that has an actual figure or a projection, so the lines use the full width of the chart even for a long budget. When the budget period runs past that month, the card subtitle says so — Budget period runs through YYYY-MM. The in-progress month and the Data through date are shown even when there is no projection yet, so a month that has only partly been billed is not mistaken for a drop in spend.

ℹ️
A forecast needs three months of accrued cost. Until then the chart says so directly — for example “Forecast appears once cost has accrued for 3 months (currently 2)” — rather than drawing a projection from too little history.

The projection reaches up to three months ahead. When the budget period ends later than that — a yearly budget, for example — the figures name the month the projection stops at instead of claiming the period end: Est. usage through month, Projected through month N%, and Within budget through month. A threshold warning is worded the same way.

Notifications

The Notifications tab manages who hears about this budget.

SectionDescription
Budget ManagerThe person responsible for the budget. Select Edit to add or remove the assignee
NotificationsReceive notifications turns alerts for this budget on or off, and the list below it is everyone notified when a threshold rule fires. Select Edit to add or remove recipients

With notifications on but no recipient, the card warns There are no recipients, so nothing is sent even while notifications are on.

Deleting a Budget

Delete a single budget from its detail page, or several at once from the list using the bulk bar. Either way a confirmation dialog names what is about to be removed, and the deletion is permanent.

When no budgets exist yet, the page shows No budgets found with Add a new budget to manage your cloud spending.
